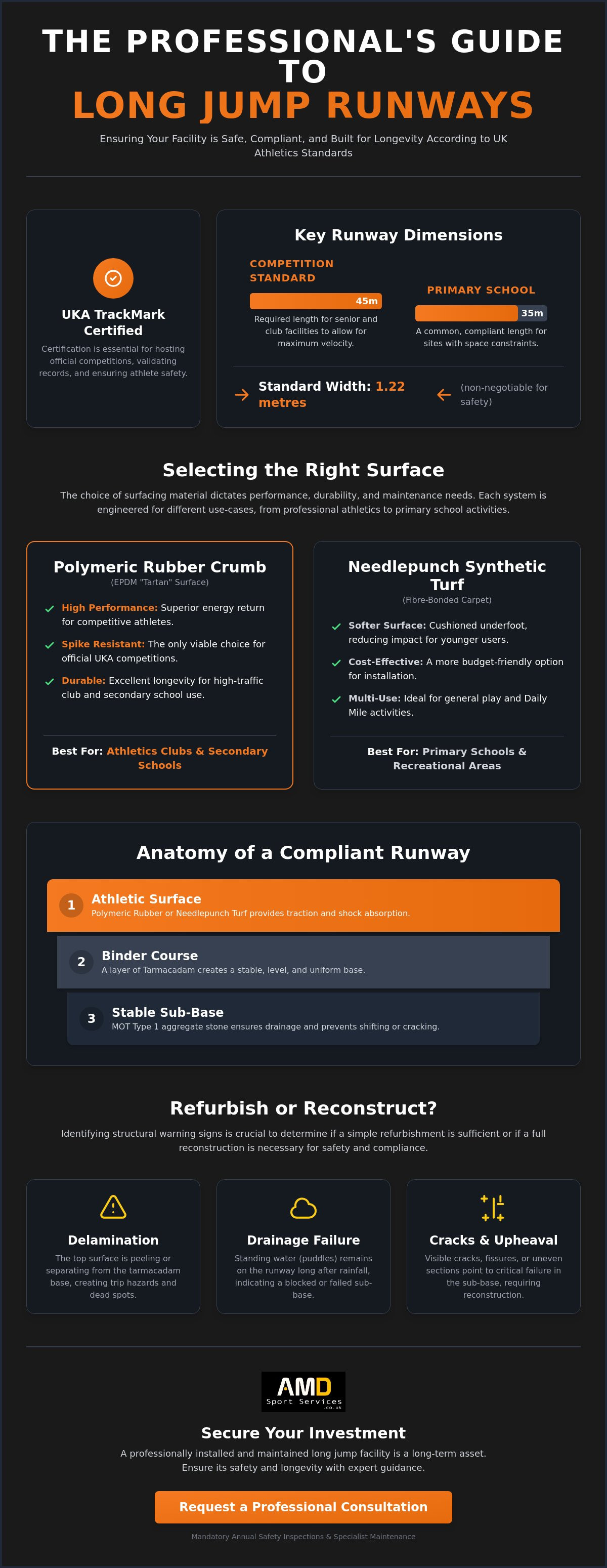

Long Jump Runway Installation: A Specialist Guide for UK Facilities
- amdsportservices
- Jun 21
- 11 min read
A long jump runway is a precision-engineered safety asset, not just a strip of rubber. When you're responsible for a school or club facility, the gap between a successful long jump runway installation and a failed safety inspection often comes down to technical adherence to UKA standards. You likely understand the pressure of balancing a strict budget with the absolute necessity of meeting TrackMark requirements. It's a common challenge to find contractors who prioritise long-term durability over a quick, superficial finish that may fail within a few seasons.
This guide provides the practical, no-nonsense information required to ensure your facility is safe, compliant, and built to last. We'll examine the specific material benefits of polymeric versus needlepunch surfaces, detail the dimensions required for official certification, and provide a clear framework for ongoing maintenance. Whether you're planning a new build or refurbishing an existing track, you'll gain a clear understanding of how to manage the process from initial groundworks to the final safety check.
Key Takeaways
Navigate UK Athletics (UKA) safety standards and TrackMark requirements to ensure your facility is competition-ready and safe for all users.
Evaluate the technical differences between polymeric rubber and synthetic turf to choose a surfacing solution that balances performance with long-term durability.
Understand the essential stages of a professional long jump runway installation, including the importance of stable sub-bases and integrated drainage systems.
Recognise the structural warning signs, such as delamination or drainage failure, that determine if a facility requires refurbishment or full reconstruction.
Secure the longevity of your investment by implementing a specialist maintenance schedule and mandatory annual safety inspections.
Table of Contents
Understanding Long Jump Runway Standards and UKA Compliance
A long jump runway is more than a surface; it is a multi-layered athletic facility engineered to provide consistent traction and shock absorption. For any facility hosting the long jump, the construction must start with a stable sub-base, typically MOT Type 1 stone, followed by a binder course of tarmacadam before the final surfacing is applied. UK Athletics (UKA) acts as the governing body that defines these technical benchmarks. Adhering to these standards isn't just about athletic performance; it's a critical requirement for facility insurance and competition validity. Without a verified long jump runway installation, any records set on the track may be voided, and the facility could fail mandatory safety inspections.
Professional installation ensures that the structural integrity of the runway meets the "Code of Practice for the Construction and Maintenance of Athletics Tracks." This document, published by the Sports and Play Construction Association (SAPCA) in conjunction with UKA, serves as the technical foundation for the industry. Choosing a specialist contractor ensures that drainage, levels, and material density are all within the permitted tolerances. Key considerations during the planning phase include:
Sub-base stability: Preventing shifting or cracking over time.
Drainage efficiency: Ensuring the runway remains usable after heavy rain.
Material uniformity: Avoiding "dead spots" that can cause athlete injury.
Key Dimensions for Primary and Senior Facilities
Standard competition runways require a length of 45 metres and a width of 1.22 metres. This allows athletes to reach maximum velocity before takeoff. However, primary schools often face space constraints. In these settings, a reduced length of 35 metres is common, paired with a slightly smaller sand pit. Bespoke sizing is often necessary for restricted school sites, provided the safety margins around the takeoff board and pit remain compliant with basic safety guidelines. Every installation must account for a 1.22-metre width to ensure a safe approach and prevent athletes from stepping off the designated track.
The Importance of UKA/IAAF Certification
Certification through the UKA TrackMark scheme, introduced in 2019, is the primary way facilities prove their quality. If a runway lacks this certification, official results cannot be recorded. Beyond competition, the technical specification affects athlete safety. The "spring" or energy return of the surface must be uniform to prevent stress injuries. Professional long jump runway installation involves testing these properties to ensure the facility is fit for purpose. UKA compliance is the baseline for all professional UK athletics installations.
Selecting the Right Athletics Surfacing: Polymeric vs. Synthetic Turf
The choice of surface for a long jump runway installation dictates the facility's lifecycle and the athletes' experience. In the UK, decision-makers typically choose between polymeric rubber and needlepunch synthetic turf. Each system has distinct mechanical properties. The SAPCA Code of Practice provides the technical framework for these materials, ensuring they meet the necessary slip resistance and force reduction standards. Climate is a major factor here. Our wet UK winters require surfaces that maintain grip even when damp and offer high-permeability drainage to prevent standing water.
Polymeric Rubber Crumb (EPDM and SBR)
Polymeric surfacing, often referred to as "Tartan," is the standard for competitive clubs and secondary schools. It consists of EPDM (Ethylene Propylene Diene Monomer) rubber granules bound with a polyurethane binder. Usually installed at a 13mm depth, it offers superior energy return and a firm approach. You can choose between a spray coat system, which is cost-effective for many schools, or a sandwich system that provides enhanced durability for high-traffic club use. This material is designed for spike use, making it the only viable choice for facilities hosting official UKA competitions.
Needlepunch Synthetic Turf
Needlepunch synthetic turf offers a different profile. It's a fibre-bonded carpet infilled with sand. This is a popular choice for primary schools because it is softer underfoot and can double as a multi-use area for Daily Mile activities. It's generally more cost-effective than polymeric systems but requires a different approach to maintenance. While it doesn't offer the same "Olympic" speed as rubber crumb, its durability in recreational settings is excellent. It withstands heavy footfall from children who may not be wearing specialised athletics footwear.
Safety is the primary concern for any facility manager. Polymeric surfaces must be tested for slip resistance to prevent injuries during the high-speed approach. Over time, these surfaces can harden, reducing their impact absorption. Needlepunch tracks, while softer, require regular brushing to keep the sand distributed and prevent moss growth. If you're unsure which material fits your site’s specific usage patterns, professional safety surfacing advice can help clarify the long-term cost implications. Maintenance isn't optional. Without a clear plan, even the best installation will degrade, leading to potential safety failures and costly repairs.
Evaluating Refurbishment versus Full Runway Reconstruction
Facility managers often reach a crossroads when an athletics track begins to show its age. It's a common dilemma: do you invest in a complete long jump runway installation or opt for a targeted refurbishment? Whilst a full reconstruction is the most thorough solution, it isn't always the most pragmatic use of a school’s capital budget. The decision hinges on the structural integrity of what lies beneath the rubber. If the foundation is sound, a professional refurbishment can extend the facility's lifespan by 10 years or more, restoring the performance levels required by World Athletics standards.
Urgent attention is required if you notice delamination, where the top wearing course begins to peel away from the base. Hardening is another critical sign; as the polyurethane binders age, they lose elasticity, which increases the risk of impact injuries for athletes. Drainage failure is perhaps the most deceptive issue. If water pools on the surface after a typical UK downpour, the internal pores of the polymeric system are likely blocked, or the sub-base has begun to fail. Ignoring these signs leads to a rapid decline in safety and competition validity.
Identifying Sub-Base Failure
The sub-base is the engine room of the runway. Most older facilities rely on MOT Type 1 stone topped with a macadam binder course. Over time, ground movement or poor initial compaction can cause these layers to shift. In modern specifications, "no-fines" concrete is often preferred for its superior drainage properties, as it allows water to pass directly through the slab rather than relying on a gradient alone. Surface repairs are futile if the underlying sub-base has subsided or cracked. If we detect significant structural movement during an inspection, a full long jump runway installation is the only way to guarantee a level, safe approach for the long term.
The Refurbishment Process
If the sub-base remains stable, refurbishment is a highly effective, lower-cost alternative to a full dig-out. The process follows a methodical sequence to ensure the new materials bond correctly to the old. It begins with high-pressure cleaning and specialised chemical treatments to eradicate deep-seated moss and algae. Once the track is decontaminated, we apply a fresh layer of polyurethane binder and EPDM rubber crumb to restore the surface's grip and shock absorption. The final stage involves renewing all line markings and ensuring the takeoff board is perfectly level with the new surface. This action-result approach ensures the facility passes its next safety inspection and remains fit for competitive use.

The Professional Installation Process: From Groundworks to Sand Pits
A successful long jump runway installation requires a methodical approach to groundworks. We begin by excavating the designated area to a depth that accommodates the structural layers without compromising the final surface level. Precise ground preparation is non-negotiable; if the sub-grade isn't compacted correctly, the entire track will eventually suffer from dips or cracking. We install pre-cast concrete edgings along the perimeter to provide a rigid boundary for the stone and tarmac layers. This ensures the surfacing remains contained and prevents lateral movement over years of use.
The drainage system must extend beneath the entire facility, including the landing pit. We install a perforated pipe network wrapped in a filter fleece to prevent silt from clogging the system. If you require a technical assessment of your current ground conditions, our team provides specialist long jump runway installation and site surveys to ensure your drainage is fit for purpose.
Landing Pit Construction and Safety Capping
Constructing the landing pit is a task of precision. For competition use, the pit typically measures 9 metres by 3 metres. We use pre-cast concrete surrounds which must be fitted with rubber safety capping. This capping is a vital safety feature that cushions the edge of the pit, significantly reducing the risk of impact injuries during a jump. Inside the pit, we lay a geotextile membrane. This layer is essential because it prevents the high-quality silica sand from mixing with the underlying sub-soil. We only use UKA-approved silica sand; its rounded grains don't compact like standard building sand, providing a safe, consistent landing for athletes.
Take-Off Board Installation
The take-off board is the focal point of the runway approach. We install adjustable steel trays into the tarmac layer to house the boards. This system allows for the easy replacement of wooden or synthetic boards as they wear down. It's critical that the board sits perfectly flush with the surrounding polymeric track. Even a few millimetres of height difference creates a trip hazard and can invalidate competition results. Regular maintenance involves checking the tray for debris and ensuring the board remains secure. For facilities catering to multiple age groups, we can install multiple trays at varying distances from the pit to accommodate different abilities.
Securing Your Investment with Specialist Maintenance and Inspections
Completing a long jump runway installation is a significant capital investment for any school or club. To ensure this asset remains fit for purpose, a proactive maintenance programme is essential. Neglect leads to rapid surface degradation and, eventually, the loss of competition certification. We take a pragmatic approach that combines our technical installation knowledge with long-term repair expertise. This ensures that minor issues don't escalate into structural failures that require a full reconstruction. A durable track is the result of consistent care, not just high-quality initial materials.
A bespoke maintenance schedule should account for your site's specific usage levels. A secondary school track used daily for PE lessons requires more frequent attention than a club facility used twice a week for training. Regular upkeep extends the life of the polymeric or needlepunch surface by preventing the accumulation of organic matter. If leaves or dirt are left to rot on the surface, they block the drainage pores, leading to standing water and moss growth. In the wet UK climate, maintaining the permeability of the track is your first line of defence against surface failure.
Routine Maintenance for Staff and Groundspeople
The most common issue we encounter is "sand migration." When athletes exit the landing pit, sand inevitably follows them onto the approach track. If left alone, this sand acts as an abrasive under the pressure of track spikes, wearing down the rubber crumb surface. Groundspeople should sweep or vacuum the first few metres of the runway after every session to prevent this wear. We also recommend regular brushing to prevent moss and algae from taking hold in the pores of the track, especially in shaded areas. Identifying early signs of thinning or hardening allows for minor patch repairs rather than a costly full resurface later.
Professional Safety Inspections
Annual safety inspections are a legal requirement for many educational institutions and local authority sites. During a specialist audit, an inspector examines more than just the surface. We check the security of the take-off board trays, the level of the sand pit surrounds, and the impact absorption of the runway itself. Compliance auditing ensures your facility meets the latest UKA standards and remains safe for student use. You can Contact AMD Sport Services to organise a professional safety audit of your athletics surfaces. Our reports provide clear, actionable advice on any necessary remedial works, helping you maintain a safe and compliant sporting environment for years to come.
Optimising Your Facility for Long-Term Performance
Managing an athletics track is a balance of technical compliance and budgetary foresight. You've seen that UKA standards provide the necessary framework for safety, whilst the choice of surfacing and the condition of the sub-base determine the facility's lifespan. Whether you're considering a refurbishment or a completely new build, the focus must remain on precision and durability. Regular maintenance isn't just a recommendation; it's a requirement to keep the facility competition-ready and safe for all users.
AMD Sport Services brings over 20 years of specialist industry experience to every project. We provide national coverage for UK schools and councils, specialising in both high-standard installations and rigorous safety compliance inspections. Our team understands the unique structural challenges of school sites and the strict requirements of TrackMark certification. Request a professional site survey for your long jump runway installation to ensure your project is handled by seasoned experts. We look forward to helping you build a facility that serves your athletes for years to come.
Frequently Asked Questions
How long does a long jump runway installation typically take?
A standard long jump runway installation usually takes between 10 and 15 working days to complete. This timeline depends heavily on the prevailing weather conditions and the complexity of the initial excavation. Once the sub-base is laid and the tarmac binder course has cured, the final surfacing can be applied relatively quickly to finish the project.
What is the best sand to use for a long jump landing pit?
You should always use washed, rounded silica sand that meets UK Athletics specifications. This specific sand type doesn't compact under pressure, which ensures a soft landing and reduces the risk of athlete injury. Standard builders' sand is unsuitable because it hardens when wet and can cause significant skin abrasions during landing.
Does a long jump runway need a specific type of drainage?
Effective drainage is a critical component of any professional long jump runway installation. We typically install a perforated pipe system beneath the stone sub-base to carry water away from the facility. Without this, the UK’s high rainfall would lead to surface pooling, which causes the rubber layers to delaminate and fail prematurely.
How often should a long jump runway be inspected for safety?
Schools and local authority facilities are required to conduct professional safety inspections at least once a year. For high-traffic athletics clubs, we recommend a secondary mid-year check. These audits identify early signs of wear, such as surface hardening or takeoff board subsidence, before they become significant safety hazards or legal liabilities.
Can we install a long jump runway on a grass surface?
You cannot install a long jump runway directly onto a grass surface. The site requires professional excavation followed by the installation of a stable sub-base, such as MOT Type 1 stone and a tarmacadam layer. Installing on grass without these foundations would lead to immediate subsidence and a dangerous, uneven approach that fails safety standards.
What is the difference between a polymeric and a needlepunch runway?
Polymeric runways are made from rubber crumb and are the standard for competitive use because they are spike-resistant and provide high energy return. Needlepunch is a fibre-bonded synthetic turf infilled with sand. It's often chosen for primary schools because it's softer underfoot and more cost-effective for recreational athletics and multi-sport use.
How much does it cost to refurbish an existing long jump pit?
The cost of refurbishing a long jump pit depends on whether the work involves a simple sand top-up and cleaning or a full replacement of the safety capping and surrounds. If the underlying concrete structure is sound, refurbishment is a highly efficient way to restore compliance and safety without the expense of a full reconstruction.
Are take-off boards adjustable for different age groups?
Take-off boards are adjustable through the use of steel trays set into the runway. These trays allow you to move the board to different distances from the sand pit, accommodating the jumping abilities of primary children, secondary students, and senior athletes. This flexibility is essential for multi-use school facilities that cater to various age groups.
